GID Current Projects

GID Current Projects

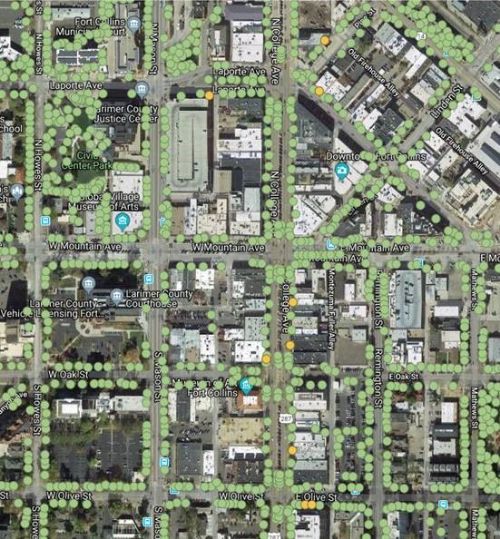

What: 2019 College Avenue Downtown Tree Pruning, Removal & Replacement Project

Schedule:

Monday, July 22nd

  • College Avenue from E Olive Street to Mountain Avenue
  • Northbound lane closure (include parking spaces) and pedestrian sidewalk detour
  • City of Fort Collins Forestry crews and SavAtree contract crews
  • Start Time: 6:00 a.m. – End Time: 11:00 a.m.
  • Three tree removals, east side of S College Ave
    • 224 S College Ave – Tony’s
    • 152 S College Ave – The Cupboard
    • 120 S College Ave – All Sales Vinyl (Old Bisetti's Restaurant)

Tuesday, July 23rd

  • College Avenue from Mountain Avenue to W Olive Street
  • Southbound lane closure (include parking spaces) and pedestrian sidewalk detour
  • City of Fort Collins Forestry crews and SavAtree contract crews
  • Start Time: 6:00 a.m. – End Time: 11:00 a.m.
  • One tree removal, west side of S College Ave
    • 151 S College Ave or 120 W Oak St – Great Western Bank

Wednesday, July 24th

  • College Avenue from Mountain Avenue to Laporte Avenue
  • Northbound lane closure (include parking spaces) and pedestrian sidewalk detour
  • City of Fort Collins Forestry crews and SavAtree contract crews
  • Start Time: 6:00 a.m. – End Time: 11:00 a.m.

Thursday, July 25th

  • College Avenue from Laporte Avenue to Mountain Avenue
  • Southbound lane closure (include parking spaces) and pedestrian sidewalk detour
  • City of Fort Collins Forestry crews and SavAtree contract crews
  • Start Time: 6:00 a.m. – End Time: 11:00 a.m.

Friday, July 26th

  • College Avenue and Oak Street – Center Medians
  • Northbound and Southbound inside lane closures
  • City of Fort Collins Forestry crews
  • Start Time: 6:00 a.m. – End Time: 11:00 a.m.

Tuesday, July 30th – Three tree removals

  • 204 Walnut Street – Rocket Jones
  • “No Parking” Signs – eight spaces
  • Start: 6:30 am
  • 310 South College Ave on the Olive Street side (two small trees) – Uncommon Apartments
  • “No Parking” Signs – from College Avenue to the alley
  • Start: 7:30 am

Wednesday, July 31st – Two tree removals

  • 200 North College Avenue on the Pine Street side – Crooked Stave
  • “No Parking” Signs – eight spaces
  • Start: 6:30 am
  • 118 North Mason on the Laporte side – Laporte Parking Garage
  • Eastbound lane closure from Mason Street to the alley
  • Start: 8:30 am
